IMPLEMENTATION PROJECT PLAN
Ask to see a preliminary implementation project plan before you make your decision. Have them prepare this plan using your company’s size, specific needs, and features rather than merely supplying a generic model. It will be a rough estimate before a full, post-sale analysis your particular details, but it should provide a reasonable approximation of implementation tasks and times. Look carefully at the following areas:
- The time between acquisition and launch
- The activities and their timeframes to make it happen
- End-user rollout activities and times
- Phased feature implementation schedule
- Expectations of your staff

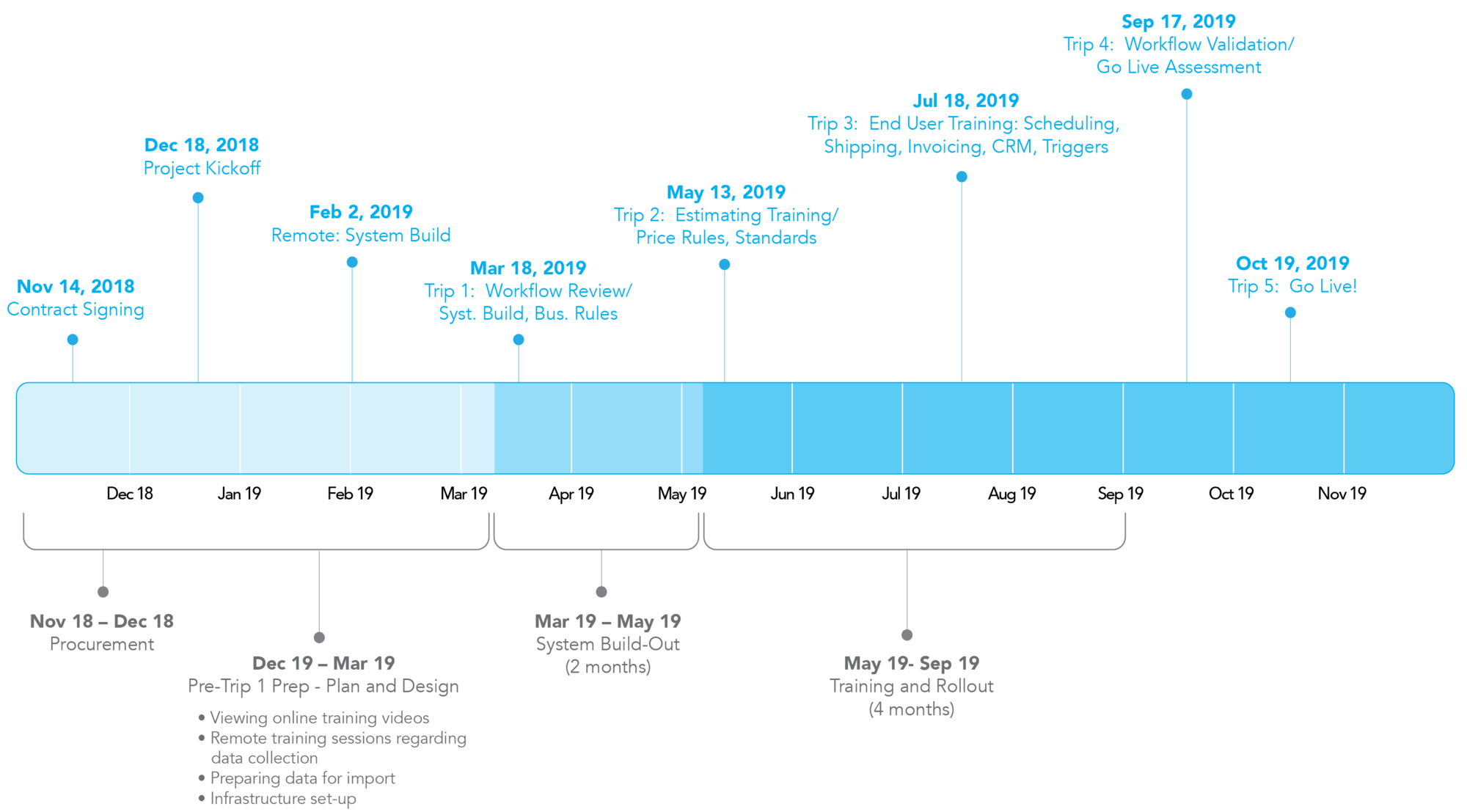

Here is an example, benchmark timeline to use as a reference:
